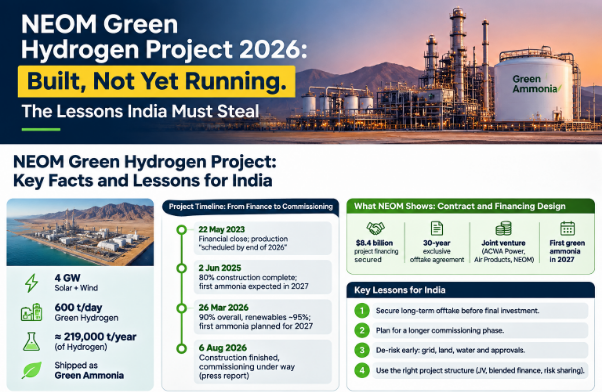

NEOM Green Hydrogen Project 2026: Built, Not Yet Running. The Lessons India Must Steal

last updated
October 27, 2026

What can India's hydrogen mission learn from the $8.4 billion NEOM project, now in commissioning?

The NEOM green hydrogen project 2026 is a finished plant waiting for its first ammonia, and its main lesson for India is contract structure before concrete. NEOM Green Hydrogen Company (NGHC), an equal joint venture of ACWA Power, Air Products and NEOM, reported 90% overall construction completion on 26 March 2026. ACWA Power's chief executive told analysts on 6 August 2026 that the building is done and the plant is in commissioning, according to Energy Intelligence, with the first green ammonia planned for 2027. The project closed its $8.4 billion financing with a 30-year exclusive buyer in place; the green ammonia contracts India signed in March 2026 run for 10 years.

‍

Where does the NEOM green hydrogen project stand in 2026?

NGHC is building up to 4 gigawatts (GW) of solar and wind power, an electrolyser plant and an ammonia unit at Oxagon, Saudi Arabia. The design output is up to 600 tonnes of hydrogen a day, shipped as green ammonia. That is roughly 219,000 tonnes of hydrogen a year at full rate (600 tonnes times 365 days; our calculation).

NGHC's 26 March 2026 release put overall construction at 90% and the renewable assets at about 95%. It says commissioning of the electrolysers and the first ammonia is planned for 2027. A 10 August 2026 Energy Intelligence report quotes ACWA Power chief executive Samir Serhan as saying that building work is finished and that commercial operations will start next year. Treat that last claim as press-reported until NGHC confirms it. A construction percentage also measures what is built, not what produces: electrolyser commissioning and first ammonia are still ahead.

Milestone What was said Source
22 May 2023 Financial close; production "scheduled to begin by the end of 2026" NGHC announcement, filed by Air Products with the US Securities and Exchange Commission
2 June 2025 80% construction complete; first ammonia availability expected in 2027 NGHC release
26 March 2026 90% overall, renewables about 95%; first ammonia planned for 2027 NGHC release
6 August 2026 Construction finished, commissioning under way (press report) Energy Intelligence

The schedule moved by about a year between the 2023 financing and today's plan. Air Products expects "a long commissioning process" before the plant reaches full production, World Fertilizer reported.

Spending is already tapering. Air Products reports that NGHC spending not funded by its own equity was $817.1 million in the nine months to 30 June 2026, against $1,981.2 million a year earlier (Air Products fiscal third-quarter 2026 results). That drop is what a project looks like when the heavy construction is behind it.

India's Green Hydrogen Projects: Why Commissioning Can Take Longer Than Planned

Commissioning timelines for India's emerging green hydrogen and ammonia industry show why reaching a final investment decision is only one milestone in a project's execution.

Consider AM Green's green ammonia complex in Kakinada, Andhra Pradesh. In a June 2026 interview with S&P Global Energy, the company's CEO, Gautam Reddy, said the first 500,000-tonne-per-year phase was targeting commissioning in July 2028. The second phase was planned six to nine months later. The same report noted that the project had initially targeted commissioning around mid-2026 following its final investment decision in 2024. The published schedule had therefore shifted by roughly two years. The interview did not establish one specific cause for the entire change.

The challenges become clearer in accounts from other Indian project developers. In April 2026, S&P Global Energy reported that renewable hydrogen and ammonia developers were facing delays related to grid connectivity, land allocation, regulatory approvals, water availability and transmission infrastructure. One awardee described a minimum one-year wait for grid connectivity through the central or state transmission utility. These dependencies can hold up commissioning even when the developer has identified the site and progressed with the plant itself.

Commissioning also does not necessarily mean immediate commercial production. In March 2024, Reuters reported that GAIL expected its 10 MW electrolyser at Vijaipur to begin producing hydrogen approximately one month after commissioning, once initial technical issues had been resolved. This highlights the distinction between completing equipment commissioning and achieving stable production.

The practical lesson for project developers is to track more than the headline commissioning date. Land and statutory approvals, grid connectivity, transmission readiness, water supply, equipment integration, initial technical issues and the ramp-up to stable production all need clear owners and realistic timelines.

Note: The dates and bottlenecks above come from published interviews and reporting. They illustrate specific project schedules and reported industry constraints. They should not be interpreted as a universal commissioning timeline for all Indian hydrogen, ammonia or renewable energy projects.

How far did NEOM drift from its first plan?

Further than the 2026 schedule suggests. A January 2022 commentary from the Center for Strategic and International Studies described NEOM as a US$5 billion green hydrogen project expected online in 2025. [dated: verify currency] The financing announced in May 2023 put total investment at $8.4 billion, and first ammonia is now planned for 2027.

Date Reported cost Reported start Source
January 2022 US$5 billion 2025 Center for Strategic and International Studies
May 2023 $8.4 billion End of 2026 NGHC announcement
March 2026 Not restated 2027 NGHC release


‍

Scope may have changed between those dates, so the comparison is not exact. [GAP: confirm whether the 2022 figure covered the same facilities as the 2023 financing.] The direction is still clear: cost rose, and start-up moved back by about two years. Indian developers pricing their first large project should include a contingency that reflects this history.

How was NEOM financed, and who carries the risk?

The NGHC announcement of 22 May 2023 puts total investment at $8.4 billion, with $6.1 billion of non-recourse debt from 23 banks and investment firms. Non-recourse means lenders can claim only the project's assets and cash flows, not the owners' other assets. The package includes what the filing calls an Euler Hermes tranche (Euler Hermes is a credit insurer). Air Products holds an exclusive 30-year offtake (a purchase contract) for all the green ammonia.

That ordering matters. The buyer was signed, the debt was raised against the buyer's contract, and then the plant was built. Debt of $6.1 billion is about 73% of the $8.4 billion total (our calculation).

What happened to Air Products' plan for the ammonia?

The buyer's own plans changed. On 30 June 2026, Air Products said it would not proceed with its Louisiana clean energy complex, and its fiscal third-quarter results show project exit charges of about $2.9 billion before tax. Those charges cover Louisiana, the Casa Grande hydrogen facility in Arizona and smaller clean energy distribution projects. NEOM is not on the list.

Air Products then finalised a marketing and distribution agreement with Yara, as stated in its July 2026 results presentation. Yara markets the green ammonia that Air Products does not sell as renewable hydrogen and is paid on commission. Air Products says the deal reduces its need for downstream green hydrogen investment. Air Products still owns one-third of NGHC and remains the sole offtaker.

The lesson is narrow and useful, and it applies to Indian developers who rely on a handful of buyers. A 30-year contract protects the project, but the buyer's downstream market can still shrink. NEOM's answer was a second route to market.

How does India's model compare with NEOM's?

India signed its green ammonia purchase agreements on 30 March 2026. The Solar Energy Corporation of India (SECI) ran bids under the SIGHT programme (Strategic Interventions for Green Hydrogen Transition), and a Press Information Bureau (PIB) release lists 10-year purchase agreements with fertiliser units. Developers named in the release include ACME Cleantech, NTPC Renewable Energy, Jakson Green, SCC Infrastructure and Oriana Power. Discovered prices run from Rs 49.75 to Rs 64.74 per kg, against an international benchmark of about €1,000 per tonne (roughly Rs 110 per kg) in the release. The release estimates about $2.5 billion in foreign exchange savings over 10 years, and Minister Pralhad Joshi has named fertilisers, refineries, steel and transport as the next focus sectors.

NEOM (Saudi Arabia) India (SIGHT ammonia contracts)
Contract length 30 years 10 years
Buyer One company, Air Products Fertiliser units (13 per PIB)
Market Export, through Yara and Air Products Domestic fertiliser plants
Status Built; the first ammonia is planned for 2027 Contracts signed on 30 March 2026

The scale gap in India's green hydrogen capacity is evident in these numbers. A PIB release of 24 March 2026 lists 862,000 tonnes a year of green hydrogen capacity awarded to 18 companies. A 25 March 2026 release from the Ministry of New and Renewable Energy (MNRE) puts commissioned capacity at about 8,000 tonnes a year and green hydrogen for refineries at Rs 387 to Rs 397 per kg, including 18% goods and services tax. Against NEOM's design rate, India's commissioned capacity is about 3.7% of one Saudi plant (our calculation). The National Green Hydrogen Mission targets 5 million tonnes a year by 2030.

India Has a Lesson in Bankable Green Ammonia

India's AM Green project in Kakinada offers a useful comparison with NEOM. The developer secured a long-term renewable ammonia off-take agreement with Germany's Uniper. In October 2026, the Asian Development Bank signed funding agreements with AM Green Ammonia (India), including a US$100 million loan sponsored by Japan’s JICA under the Leading Asia’s Private Infrastructure Fund 2.

The project shows why a credible purchaser and development finance matter. But it also reveals that lenders look beyond the headline production capacity.

ADB's public project documentation identifies detailed requirements around environmental management, water use, hazardous-material handling, ammonia process safety, emergency planning, transmission infrastructure and land access. A final quantitative risk assessment must be incorporated into plant design and emergency planning before commissioning. Phase 2 is also contingent on securing additional long-term offtake arrangements.

The lesson for India is clear: a production target is not the same as a bankable project. Developers need credible buyers, financing, safe plant designs, completed infrastructure arrangements and a realistic execution plan. NEOM and AM Green differ in scale and commercial structure, but both illustrate the importance of connecting demand, capital and project readiness.

What should Indian developers copy from NEOM?

NEOM is one plant with one anchor buyer, so not every part transfers. These six points do, and each rests on a fact from the sources above.

  1. Sign the buyer first. NEOM raised $6.1 billion of debt against a 30-year contract. A 10-year agreement shortens the period over which lenders can be repaid from a guaranteed buyer, so Indian developers should test early whether their banks accept that tenor or want a longer one. The PIB release itself says the agreements support financial closure.
  2. Build the power with the plant. NEOM's 4 GW of solar and wind sit inside the same project, and NGHC reported them about 95% complete in March 2026, well ahead of electrolyser commissioning. Power supply is then a project asset, not a third-party risk.
  3. Budget for commissioning. Air Products expects a long ramp to full production. Keep a full-rate year out of the base case on the day of the first product.
  4. Line up a second route to market. Air Products' Yara agreement shows how an anchor buyer can add distribution without giving up the contract. A developer selling to a handful of fertiliser units could ask what happens if one of the plants stops buying.
  5. Publish milestones. NGHC released dated progress figures at 80% (June 2025) and 90% (March 2026), which lets anyone check the schedule against the plan. Indian developers benefit from the same discipline when lenders and buyers watch.
  6. Price in cost and schedule drift. NEOM's cost and start date both moved between 2022 and 2026. Build contingency and delay into the base case.

What does the gap mean for Indian developers?

India has contracts and incentives in place, and awarded capacity is roughly four times NEOM's design output in tonnes of hydrogen (862,000 against about 219,000, our calculation). The gap sits between award and operation. A PIB release of 25 March 2026 counts about 8,000 tonnes a year commissioned, and the National Green Hydrogen Mission's 5 million-tonne target for 2030 is more than 20 times NEOM's design rate. Moving awards into operation decides whether the mission hits its numbers.

What does NEOM not tell India?

NEOM has not published a delivered price for its ammonia. [GAP: no public price for NEOM ammonia was found; check company disclosures.] India's anchor market is also different: domestic fertiliser and refinery demand, not a single export buyer. Whether Indian green ammonia can compete in export markets is untested, and developers with export plans will also face the EU's renewable fuel rules, as covered in our CBAM and green hydrogen guide [link: add URL of the CBAM blog once published]. And NEOM is not yet producing, so its operating performance is still unknown.

To build the project finance, policy and technical skills behind decisions like these, see evACAD's Advanced Green Hydrogen Course.

‍

Graphic showing four diverse male portraits connected by orbiting colored dots around a central figure.
Take the Next Step with evACAD
Get Started

Frequently Asked Questions

Is the NEOM green hydrogen project complete?
NGHC reported 90% overall construction on 26 March 2026. Press reports of August 2026 say ACWA Power's chief executive described construction as finished and the plant as in commissioning. First ammonia is planned for 2027.
When will NEOM start producing green ammonia?
NGHC says electrolyser commissioning and first green ammonia availability are planned for 2027. The 2023 financing announcement had scheduled production to begin by the end of 2026.
Who owns NEOM Green Hydrogen Company, and who buys the output?
ACWA Power, Air Products and NEOM own equal shares. Air Products holds an exclusive 30-year offtake and has signed a commission-based marketing agreement with Yara.
How big is NEOM compared with India's green hydrogen capacity?
NEOM is designed for up to 600 tonnes of hydrogen a day, about 219,000 tonnes a year. India had about 8,000 tonnes a year commissioned as of February 2026 and 862,000 tonnes a year awarded, per government releases.
What can Indian developers learn from NEOM?
Secure long-term purchase contracts before financing, build the renewable power with the plant, plan for a slow commissioning ramp and add a second route to market.
